DD Timeline: The 14-Week Critical-Path Playbook (2026)
Co-founder at Peony. Former M&A at Nomura, early-stage VC at Backed VC, and growth-equity / secondaries investor at Target Global. I write about investors, fundraising, and deal advisors from the deal-side perspective I spent years in.
DD Timeline: The 14-Week Critical-Path Playbook (2026)
Quick answer: M&A due diligence is not a single timeline. It is 6+ parallel workstreams (financial, legal, tax, commercial, HR, IT/cyber, environmental, regulatory) racing against ONE serial critical-path chain: QoE → SPA → financing → RWI bind → HSR clock → close. Roughly 40% of deals miss their close date per BCG, and two-thirds of those need 3+ extra months. 88% of dealmakers report sign-to-close has lengthened in the past 3 years per the 2026 cross-border survey. The three timing bottlenecks I see kill deal momentum most often: (1) HSR's Q1 2026 $133.9M threshold and the Second Request risk; (2) the Week 9 RWI insurance binding gate; (3) third-party consents on cross-border deals. Compression is possible on parallel workstreams (AI-tooled QoE drops from 3-6 weeks to 5-10 days). The critical-path chain is structurally rigid.
Last updated: May 2026
Why I wrote this
I have run buy-side and sell-side due diligence on hundreds of deals, and I have watched far more from the data room side. At Peony we now serve more than 8,000 teams, and our 733-deal Q3 2025–Q3 2026 platform benchmark gives me a fairly clear picture of where modern DD timelines actually break.
The standard mental model — "DD takes 8-12 weeks" — is wrong in a specific way. DD doesn't take 8-12 weeks as a single block. It runs 6+ workstreams in parallel for the first 4-6 weeks, then funnels into a serial critical-path chain that has its own rigid cadence (QoE finalize → SPA negotiation → financing commitment → RWI binding → HSR clock → close). Compressing the parallel workstreams (via AI-tooled QoE, AI-tooled legal review, rapid cyber assessment) saves time on the DD report but does not necessarily save time on the close date. The critical-path chain is the floor.
This post is the working playbook I would hand to a PE deal-team VP coordinating six external advisors, a sell-side CFO trying to keep Day 7 / 14 / 30 doc-population milestones, an M&A lawyer running SPA negotiation against a Week 9 RWI binding gate, or a corp dev VP managing the parallel integration-planning workstream alongside DD. The six frames in this playbook (6-Workstream Critical-Path Map, VDR Population Velocity Curve, Confirmatory-DD Cliff, Third-Party Consent Long Pole, RWI Underwriting Lock, HSR-Tied Timeline) come from cross-referencing the 2024-2026 deal record with the workstream-level mechanics I have observed.
Important framing note: This post complements rather than duplicates Peony's other DD timing coverage. The M&A Due Diligence Process Guide covers the 6-phase process and the "timeline by deal size" question. The M&A Data Room playbook covers the data room setup and how that drives DD timeline. This post is the critical-path orchestration view — the workstream-level mechanics that determine whether you actually close on time.
What is the canonical 14-week M&A DD timeline?
The canonical mid-market M&A DD timeline runs 14 weeks from LOI signing to close, with a 6-week intensive DD phase embedded inside it.

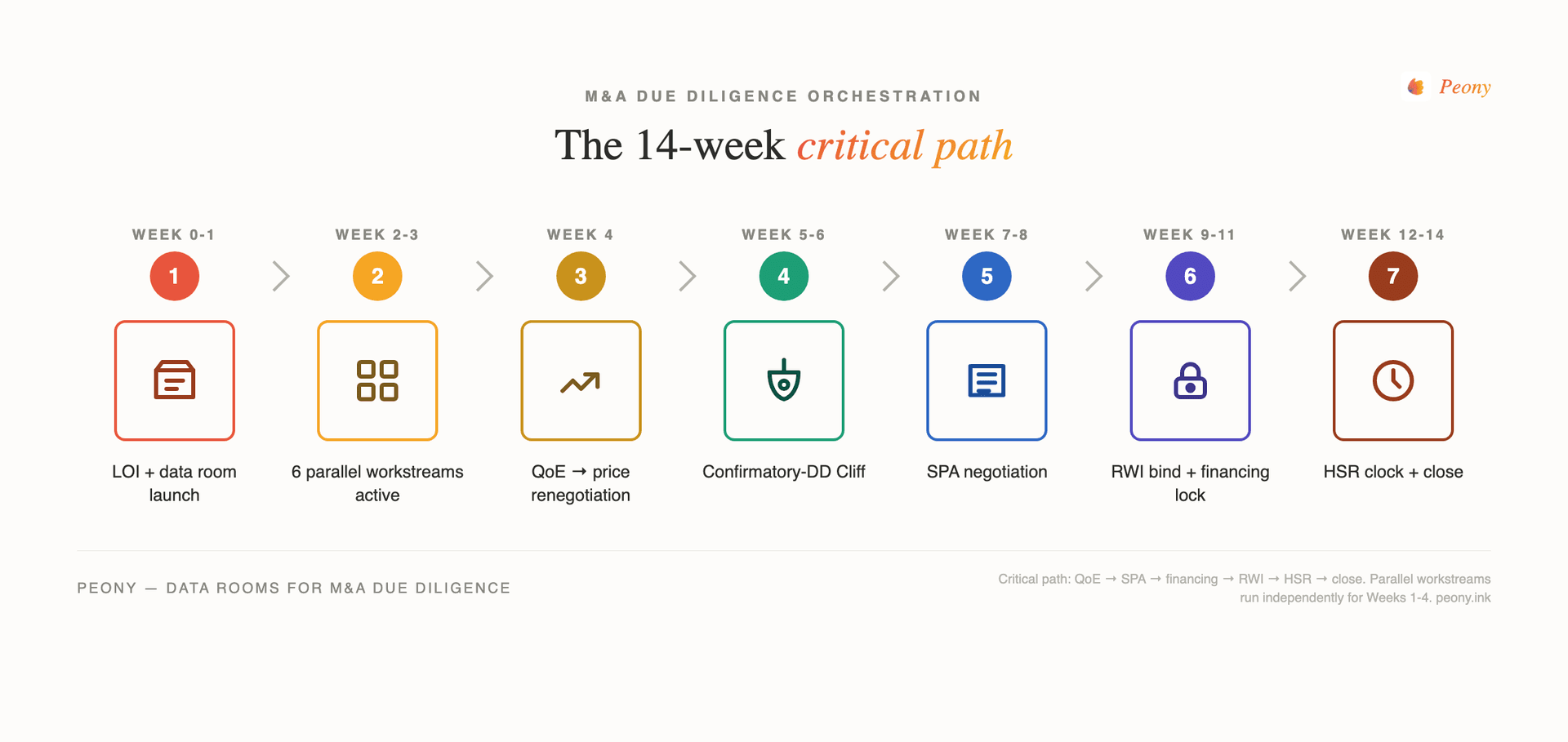

The standard 14-week sequence:
- Week 0 — LOI signing + exclusivity period begins. Data room access granted. Workstream coordinators identified across legal, financial, tax, HR, commercial, IT/cyber.
- Weeks 1-2 — Day-1 data room population sprint. Target: 50-60% uploaded by Day 7, 80% by Day 14. Initial DDQ responses begin.
- Weeks 3-4 — Quality of Earnings preliminary findings surface. Working capital peg negotiation begins. Price renegotiation window opens.
- Weeks 5-6 — Confirmatory DD findings surface (the "Confirmatory-DD Cliff"). Management interviews. Site visits. Customer reference calls. Cross-functional risk register.
- Weeks 7-8 — SPA negotiation. Disclosure schedules drafted. Reps and warranties scoped. Indemnification baskets sized.
- Week 9 — RWI insurance binding gate. Final DD reports + DDQ Q&A logs + agreed SPA reps required.
- Weeks 10-11 — Financing commitments firmed. Credit committees approve. Debt commitment letters issued.
- Weeks 12-13 — Regulatory clearance (HSR 30-day clock for deals >$133.9M per FTC's Q1 2026 update).
- Week 14 — Closing.
The 6-week intensive DD phase per Dealroom's 2026 6-step DD framework runs Days 1-42: Days 1-7 (Week 1) data room launch + initial requests; Days 8-21 (Weeks 2-3) first-pass functional reviews across legal/financial/commercial/tech/HR in parallel; Days 22-28 (Week 4) management interviews + site visits; Days 29-35 (Week 5) synthesis + IC memo + cross-functional risk register; Days 36-42 (Week 6) final negotiations + sign-off.
Variance by deal size:
- Small acquisitions under $10M — compress to 8-10 weeks total. QoE may not be commissioned (legal + financial review only). RWI insurance often not purchased. HSR usually not applicable.
- Mid-market $50M-$500M — canonical 14-week timeline. Most workstreams active. RWI common. HSR applicable above $133.9M.
- Large cross-border $500M-$5B — 18-30 weeks. Multi-jurisdictional regulatory (HSR + EU EUMR + UK NSI + German FDI + CFIUS as applicable). RWI scope expanded.
- Mega-deal $5B+ — 6-12 months or longer. Substantial compliance under HSR Second Request risk. Multiple FDI screenings. Complex divestiture commitments.
The 14-week canonical is the median for $50M-$500M private-target deals where neither extreme delay nor extreme compression applies. The 2024-2026 reality is that 40% of deals miss this median by months.
Why is sign-to-close lengthening — what's the 2024-2026 data?
Sign-to-close timelines have lengthened materially across 2024-2026. The anchored data:
Goodwin Procter's October 2025 analysis found sign-to-close for PE deals increased 64% from 2023 to 2024. The drivers Goodwin cites: regulatory complexity (HSR Second Request risk, FDI screenings), expensive debt (credit spreads, financing-commitment delays), expanded DD scope (cyber DD, ASC 606 revenue recognition), and RWI demands (carriers requiring thorough DD reports before binding). Goodwin's headline framing: "it is increasingly common for M&A transactions to be repriced or abandoned entirely."
The SRS Acquiom + Mergermarket Q3 2024 survey of 150 senior bankers reported 59% say 1-3 months were added to DD timelines. The same survey found 97% of senior bankers cite cybersecurity as expecting the greatest DD scrutiny and 45% of bankers call tech/IT review the most expensive workstream. Deloitte's 2025 M&A Trends Survey found 88% of corporate leaders pivoting M&A strategies for new issues and emerging threats with cybersecurity at the center of that shift. Morrison Foerster's 2025-2026 outlook corroborates the tech-DD-cost finding through its broader tech M&A survey.
The 2026 cross-border survey reports 88% of dealmakers say sign-to-close has lengthened in the past 3 years and 74% have deals prevented from closing due to entity/SPV delays.
BCG's 2024 M&A Report: approximately 40% of deals don't close on their original target date, and of those delayed, nearly two-thirds need 3+ extra months (note: 2024 vintage data, but no 2025-2026 successor benchmark superseded the BCG numbers as of May 2026) rather than a few weeks.
The structural drivers behind the 2024-2026 lengthening:
- HSR Q1 2026 rule update — threshold rose to $133.9M (up 6%); top-tier filing fee rose to $2.46M; enforcement intensity continued.
- RWI insurance now near-standard in mid-market and sponsor-backed deals per Kennedys' 2026 RWI outlook (ABA Deal Points Study historically tracked 55-65% adoption). RWI carriers demand thorough DD reports + DDQ logs before binding at Week 9, adding 1-2 weeks of carrier audit.
- Cyber DD expansion — 22% of 2026-cohort deals now include cybersecurity reps (up from 5% in 2024 per SRS Acquiom's 2026 Deal Terms Study covering 2,300+ deals and $569B); cyber DD M&A market projected at $5.163B in 2025; 74% of target codebases contain high-risk vulnerabilities per Synopsys OSSRA 2024 report cited in Human Renaissance's 2025 M&A Tech DD benchmark.
- Third-party consents — lender consents, customer/landlord consents, anti-assignment provisions in major contracts compound on cross-border deals.
- ASC 606 revenue recognition complexity — adding QoE scope and lengthening QoE timelines.
The takeaway: most deals do not miss their close date by a small margin. They miss by months or get repriced.
What are the 6+ parallel workstreams and how do they coordinate?
M&A DD runs 6 core parallel workstreams (sometimes 8-9 with industry-specific add-ons). Each has its own timing, dependencies, and bottleneck pattern.
| Workstream | Standard timing | Cost (mid-market) | Bottleneck source |
|---|---|---|---|
| Financial DD / QoE | Weeks 1-4 (3-6 weeks) | $20K-$75K | Target's audited financials availability |
| Legal DD | Weeks 1-5 (30-90 days) | $50K-$250K | Manual document review labor |
| Tax DD | Weeks 2-3 (5 days-3 weeks) | $15K-$75K | QoE adjustments dependency |
| Commercial DD | Weeks 1-3 + Week 5-6 ref calls | $25K-$150K | Customer ref calls held until close certain |
| HR DD | Weeks 2-4 (6 weeks) | $20K-$100K | Management retention discovery late |
| IT/Tech/Cyber DD | Weeks 2-4 (5 days-3-4 weeks) | $30K-$250K+ | Codebase complexity + cyber-incident history |
| Environmental DD (industrial/RE) | Phase I 2-4 weeks | $5K-$30K Phase I | 180-day Phase I validity expiry |
| Regulatory DD (sector-specific) | Varies | Varies | HSR / CFIUS / FDA clocks |
| Third-Party Consents | All deals | $20K-$100K | Lender / landlord / customer responsiveness |
Financial DD / Quality of Earnings (Weeks 1-4)
Standard mid-market QoE runs 3-6 weeks depending on data quality and management responsiveness per Anders QoE Guide and DueDilio's 2025 QoE Analysis Guide. Multi-location or complex deals run 6-8 weeks. Big Four "compressed" QoE with AI tools can run as low as 5 days for clean mid-market targets. Cost runs $20K-$75K for mid-market QoE reports.
Critical gate: target's audited financials must be available. If the PCAOB audit lapsed, this is the first bottleneck of the entire deal. Output drives purchase price renegotiation in Weeks 3-4 and the working capital peg.
Legal DD (Weeks 1-5)
Standard 30-90 days depending on target complexity. Document review consumes 1-2 weeks of attorney-hours and is the typical labor bottleneck (not document complexity). Mid-market 6-week standard per Dealroom 2026.
Key deliverable: legal DD findings report drives SPA reps + conditions precedent. Per Emma Legal's bottleneck analysis, AI-assisted contract review tools can drop 1-2 weeks of attorney-hours to 3-5 days for standard contract types.
Tax DD (Weeks 2-3)
Tax DD is structurally downstream of QoE — it depends on QoE adjustments to normalized EBITDA as a pure input. Modern AI-tooled tax DD runs 5 days to 3 weeks for mid-market. Section 382 study required for stock deals due to NOL limitation post-ownership change at 5% shareholder thresholds per Plante Moran's June 2025 Section 382 analysis.
Commercial DD (Weeks 1-3 + customer reference calls Week 5-6)
First-pass commercial DD (market positioning, competitive landscape, growth model) runs Weeks 1-3. Customer reference calls are typically held until Week 5-6 when closing is "nearly certain" per Allegrow's DD navigation guide — because customer ref calls signal imminent close to the seller's customer base. Premature customer ref calls leak deal news and create customer-anxiety risk for the seller.
HR DD (Weeks 2-4)
Standard 6-week middle-market timeline. Inputs: org chart + comp + equity plans + executive contracts. The structural bottleneck: management retention agreements often discovered missing late (Week 5-6) — the strongest single late-stage walk-away risk for PE buyers per the WTW 2024 M&A Retention Study where 28% of acquirers have no key-person retention plan at all. See our Hard vs Soft DD playbook for the soft-DD-side of HR risk management.
IT / Tech / Cyber DD (Weeks 2-4)
The fastest-growing and most expensive workstream. Rapid cyber assessment: 5-7 days. Comprehensive cyber + tech DD: 3-4 weeks. 97% of senior bankers cite cybersecurity as expecting the greatest DD scrutiny per the SRS Acquiom + Mergermarket Q3 2024 senior banker survey of 150 bankers. 45% of bankers call tech DD the most expensive workstream per SRS Acquiom Q3 2024. 74% of target codebases contain high-risk vulnerabilities per Synopsys OSSRA 2024 report cited in Human Renaissance's 2025 M&A Tech DD benchmark. US data breach liability averages $10.22M per IBM Cost of Data Breach 2025. Cyber DD M&A market projected at $5.163B in 2025 per Centri Consulting's cyber-DD analysis. If a major security overhaul is required, expect 6+ months remediation post-close — freezing the integration roadmap.
Environmental DD (Industrial / RE only)
Phase I ESA: 2-4 weeks standard. Phase I valid only 180 days for AAI defense — must be re-pulled if the deal slips past 180 days post-Phase-I per Acquisition Stars Environmental DD primer. Phase II (if RECs identified): 6-12 weeks. Manufacturing facilities regularly trigger Phase I RECs (chemical storage, USTs, floor drains, adjacent industrial). ASTM E1527-21 is the EPA-adopted standard since 2023.
Regulatory DD (sector-specific)
HSR for deals >$133.9M: 30-day clock. CFIUS: 30 days short-form / 45 days long-form / 105 days max with investigation + extension per Treasury's CFIUS overview. FDA QMSR effective February 2 2026 for medical device deals per Holland & Knight's FDA 2026 outlook. 2026 CFIUS "Known Investor Program" proposed for frequent filers — reduces review burden for repeated investors.
Third-Party Consents (cross-workstream, ALL deals)
Lender consents, landlord consents, counterparty consents (anti-assignment in major contracts), customer SaaS consents, franchisor consents. "Consent matrix" must be mapped Week 1 — deals that defer consent mapping to Week 5-6 typically slip 30-90 days.
The coordination rule across these workstreams: they run independently for Weeks 1-4, then re-coordinate at Week 5-6 synthesis (cross-functional risk register), and again at Week 7-8 SPA exchange. Workstream coordinators typically use a single "DDQ master" tracker plus a Q&A workflow in the VDR. Peony's visitor groups allow workstream-by-workstream permissioning so each external advisor sees only their assigned scope.
Frame 1: What's the 6-Workstream Critical-Path Map?
The critical path is the SERIAL chain that cannot be parallelized: QoE finalize → working capital peg → SPA negotiation → financing commitment → RWI binding → HSR filing → HSR 30-day clock → close. Everything else runs in parallel.
The mechanics:
- QoE must finalize before working capital peg can be set
- Working capital peg drives SPA price + adjustment mechanism (90%+ of private deals now have a working capital PPA per SRS Acquiom's 2025 Working Capital Study covering 1,200+ deals and $298B, up from ~50% a decade ago)
- SPA must be agreed before financing commitments can be drawn down (debt commitment letters condition on near-final docs)
- RWI carrier needs final DD reports + DDQ Q&A log + agreed SPA reps before binding at Week 9
- HSR can only file after signing (signing requires SPA agreement)
- Cannot close before HSR 30-day clock expires (if deal value >$133.9M per 2026 thresholds)
What CAN run in parallel:
- Legal corp records review + Financial QoE
- IT / cyber scan + Commercial market study
- HR org chart review + Environmental Phase I
- Tax structuring + Regulatory consent matrix mapping
The structural implication for deal teams: AI-tooled compression on parallel workstreams saves time on the DD report but does NOT change close date if the critical-path chain runs at its full duration. Most deal teams underinvest in critical-path compression (early QoE engagement before LOI signing, early SPA drafting starting Week 1, early RWI carrier engagement starting Week 3) and overinvest in parallel-workstream compression (AI-tooled QoE, AI-tooled legal review). The result is a faster DD report but the same close date because the SPA-financing-RWI-HSR sequence still takes its time.
For sellers running sell-side prep, this is the case for vendor DD (VDD): running confirmatory DD on yourself 90 days pre-marketing surfaces findings before the buyer does and lets the QoE, working capital normalization, and SPA framework start earlier post-LOI per the sell-side DD 90-Day Prep Pyramid.
Frame 2: What's the VDR Population Velocity Curve at Day 7 / 14 / 30?
The standard mid-market benchmark for data room population velocity:
- Day 7 — 50-60% of materials uploaded (corporate records, financial statements, key contracts, basic legal docs)
- Day 14 — 80% uploaded (most workstreams have substantial materials available for review)
- Day 21 — 95% uploaded (only confirmatory and management-interview docs missing)
- Day 30 — 99%+ uploaded with only late-arriving custom requests outstanding
In the Q3 2026 edition of our 733-deal benchmark, the median room took 12.6 days from first opening to its first outside viewer, with a median of 5.5 bidders per room. By the end of the first week of bidder access, reading patterns (which bidders are reading deeply, which are skimming) are already an early read on which bidders will return for confirmatory DD and which will drop. Slow-uploading sellers (Day 14 at 60% rather than 80%) typically lose 2-3 weeks on the close date because critical-path workstreams (QoE in particular) cannot complete on schedule.
The most common Day 7 misses I see:
- Audited financials for prior 3 years — target's auditor often slow on year-end statements; missing audited financials blocks QoE
- Cap table and equity ledger — target's law firm slow to provide; blocks legal DD on corporate structure
- Customer contract catalog — target sales team often disorganized; blocks commercial DD on customer concentration
- IP assignment chain documentation — the single most-common Week 5-6 surprise gap; missing work-for-hire agreements for contractor-built code or product IP
- Compensation and equity grant histories — target HR team often slow; blocks HR DD on management retention
Peony's AI auto-indexing accelerates the Day 7 / 14 / 30 curve by classifying uploaded documents into standard DD categories in under 3 minutes — typical sell-side teams see Day 14 80% upload completion rather than the Day 21 80% completion typical of manual folder organization. Page-level analytics make the bidder-engagement-accuracy signal actionable: by Day 7, the deal team can identify which 30-50% of bidders are likely to return for confirmatory DD.
Frame 3: Why do most deal-killers surface Week 5-6 (the Confirmatory-DD Cliff)?
The Confirmatory-DD Cliff is the structural reality that most deal-killing findings surface in Weeks 5-6 of DD, not Weeks 1-2.
The mechanics: Weeks 1-2 are document review (data room scan, contract review, financial-statement scrutiny) — a high-volume, low-depth activity. Weeks 5-6 are confirmatory DD (management interviews, customer reference calls, site visits, deep-dive on flagged issues, second-pass review) — a low-volume, high-depth activity that often surfaces findings that get a deal repriced or killed.
The pattern across 2024-2026 deals I've worked on or observed:
- Management interviews in Week 4-5 surface key-person flight risk that wasn't visible in the org chart. The classic case: a single account manager controlling a customer relationship worth >10% of revenue, with no retention plan beyond their at-will employment.
- Customer reference calls in Week 5-6 surface customer-loyalty issues tied to specific account managers rather than the brand or product. Customers who say "I'd follow [account manager] anywhere" are signaling structural transferability risk.
- Second-pass legal review in Week 5 surfaces missing IP assignment chains or change-of-control termination rights in major customer contracts that weren't flagged in the first-pass DDQ response.
- HR DD in Week 5-6 surfaces missing management retention agreements — the strongest single late-stage walk-away risk per WTW's 2024 M&A Retention Study where 28% of acquirers have no key-person retention plan at all.
- Operational DD site visits in Week 4 surface process-maturity issues that aren't visible in process documentation.
- Confirmatory tax DD in Week 5 surfaces state nexus or transfer pricing issues that initial Week 2-3 review missed.
The strategic implication: deal teams should NOT assume that a clean Week 1-2 DDQ response means the deal is clean. The cliff is real and structurally late. Approximately 30-40% of total DD budget should be reserved for Week 5-6 deep-dive scope — held back from the initial Week 1-4 burn rate.
For sellers running sell-side prep, the Cliff is the case for vendor DD: running confirmatory DD on yourself 90 days pre-marketing surfaces the same findings before the buyer does, letting the seller remediate or disclose proactively rather than reactively per the sell-side DD 90-Day Prep Pyramid.
Frame 4: When do third-party consents become the long pole on cross-border deals?
Third-party consents are the most-overlooked timing risk in M&A DD — and they often become the long pole on cross-border deals. The five most common consent categories and their typical timelines:
| Consent type | Typical timeline | Notes |
|---|---|---|
| Lender consents (change of control) | 30-60 days | Longer for syndicated facilities |
| Landlord consents | 30-60 days | Common in real estate leases |
| Counterparty consents (anti-assignment in major contracts) | 30-90 days | Customer SaaS contracts typically 90+ days |
| Franchisor consents | 30-90 days | Standard franchise agreement provisions |
| Customer consents on regulated services | 60-120 days | Healthcare, financial services, government contracts |
Cross-border deals compound consent risk because foreign-direct-investment (FDI) screenings layer on top of HSR/CFIUS:
- EU EUMR — Phase I 25 working days, Phase II 90 working days
- UK NSI Act — 30 working days mandatory review
- German FDI — 2-month review (extendable)
- France FDI — 30 business days (extendable to 45)
- Japan FEFTA — 30-day prior notification
The 2026 cross-border survey reports 88% of dealmakers say sign-to-close has lengthened in the past 3 years and 74% have deals prevented from closing due to entity/SPV delays. Approximately 30-50% of cross-border deals slip past their target close because of third-party consents (versus ~15% of pure-domestic deals).
The structural rule for deal teams: every deal should produce a "consent matrix" in Week 1 of DD listing every material contract requiring third-party consent, the expected timeline, and the responsible owner. Deals that wait until Week 5-6 to map consents typically miss their close date by 30-90 days.
Per Settles Law's third-party consent primer and CMM's consent guide: "consents and approvals are the first gate to closing an M&A transaction." Missing or late consents convert from a documentation issue to a closing condition issue, and closing conditions cannot be unilaterally waived without triggering a material adverse change (MAC) clause.
Frame 5: What gates the RWI Underwriting Lock at Week 9?
The Week 9 RWI insurance binding gate is one of the three timing gates I most commonly see kill deal momentum. The mechanics: a buyer purchasing R&W insurance (now near-standard in mid-market and sponsor-backed deals per Kennedys' 2026 RWI outlook; the ABA Private Target M&A Deal Points Study historically tracked 55-65% adoption across 2023-2024 vintages) must complete underwriting before signing, with the policy binding at signing and issuing at or just before signing.
The standard RWI underwriting timeline per McDermott Will & Emery's RWI guide:
- Preliminary submission to non-binding quotes: 2-4 business days
- Formal underwriting process: 1-2 weeks
- Underwriting plus binding: 7-10 business days if responses are prompt
- Overall: 2-3 weeks total
What gates the bind:
- Final DD reports from all workstreams — QoE, legal, tax, HR, IT/cyber, commercial — must be substantially complete
- DDQ Q&A logs must be substantially complete
- Agreed SPA reps and warranties must be in place
- Disclosure schedules must be substantially drafted
Without these, the RWI carrier cannot complete its own coverage-scope analysis. Carriers will not shortcut.
The 2026 RWI pricing per Gallagher's 2026 RWI outlook:
- Premium: 2.0-4.0% of coverage limit (most deals 2.25-3.25% in competitive market)
- Retention: 0.5-1.5% of EV at policy inception, dropping to 0.25% after Year 1
- Coverage limit: typically 10% of EV
- Example $50M deal: $5M coverage, $250K retention, ~$125K-$200K premium
Strategic buyers often absorb both premium and retention in competitive auctions per Kennedys' 2026 RWI outlook.
The structural risk: any DD workstream not professionally scrutinized gets excluded from RWI coverage. Under-diligenced cyber risk, under-diligenced HR retention, under-diligenced environmental — all get exclusion endorsements that shift risk back to the buyer's balance sheet. The 2026 market is buyer-favorable on premium but seller-favorable on exclusions — carriers will exclude where DD is thin.
For deal teams: engage the RWI carrier in Week 3 (not Week 7) so the carrier audit can run in parallel with the late-DD-stage workstreams rather than serially after them. The 1-2 weeks of carrier audit time is often the difference between Week 9 binding and Week 11 binding.
Frame 6: How does the HSR Q1 2026 rule shift change deal timing?
The Hart-Scott-Rodino Q1 2026 thresholds went into effect February 17, 2026 per the FTC's January 2026 announcement. The updated thresholds and implications:
- Size of transaction: $133.9M (up from $126.4M in 2025, +6%)
- Size of person: $267.8M / $26.8M
- Section 8 interlocking directorate threshold: $54.4M (up from $51.4M)
- Filing fees: $35,000 (smallest tier) to $2.46M (top tier), up from $2.39M
- 30-day initial waiting period: unchanged
- Cash tender offers: retain 15-day initial waiting period (strategic-buyer advantage)
Sources: Cleary Gottlieb's 2026 HSR analysis, Pillsbury's 2026 HSR alert, Greenberg Traurig's 2026 HSR update.
For 2026 sub-$133.9M deals, HSR is not a critical-path concern — only larger deals hit the clock. For deals at or above the threshold, the 30-day clock is a structural floor on close date from filing.
The Second Request risk is the real time-killer. If the FTC or DOJ issues a Second Request, the 30-day clock tolls until parties certify "substantial compliance" — typically MONTHS of document collection, privilege review, and data extraction in agency-specified formats. The 30-day clock then restarts from substantial-compliance certification. High-scrutiny sectors for 2026 Second Requests: healthcare consolidation, big tech (acquisitions of independent platforms), defense (especially AI/cyber), semiconductors, energy (especially renewables), pharma.
For cross-border deals, the regulatory clock extends beyond HSR:
- CFIUS: 30 days short-form, 45 days long-form, 105 days max with investigation + extension per Treasury's CFIUS overview
- EU EUMR: Phase I 25 working days, Phase II 90 working days
- UK NSI Act: 30 working days mandatory
- German FDI: 2-month review (extendable)
The deal-team rule for HSR: assume the 30-day clock will run in full and plan close 30 days after signing. Assume Second Request risk if the deal is in a high-scrutiny sector. For deals below $133.9M, HSR doesn't apply but state antitrust attorneys-general may scrutinize healthcare deals under state-specific premerger filing requirements (Connecticut, California, Washington, New York increasingly active).
Honest comparison: which VDR fits which deal-size band?
| Deal-size band | Recommended VDR | Why |
|---|---|---|
| $5M-$50M EV | Peony, FirmRoom, iDeals starter | Fast setup, $52-100/admin/month pricing, AI auto-indexing for sell-side speed |
| $50M-$500M EV | Peony, iDeals, Firmex, Ansarada | Workstream-by-workstream permissioning + audit trail for RWI underwriting |
| $500M-$1B EV | Datasite, Intralinks, Peony (with custom) | Institutional integrations with QoE providers, law firms, RWI underwriters |
| $1B-$5B EV | Datasite, Intralinks | Enterprise workflow + dedicated workstream platforms (Litera Transact, Allvue) |
| $5B+ EV | Datasite, Intralinks (with bank-led integration) | Bank-managed VDR environments; complex divestiture handling |
Datasite — the dominant enterprise VDR for $1B+ deals — owns the enterprise band on institutional integrations with QoE providers (EY-Parthenon, Alvarez & Marsal, BDO), law firms (Kirkland, Latham, Skadden), and RWI underwriters (AIG, Beazley, Liberty Mutual). Intralinks Dealspace competes head-to-head in the mega-deal segment with similar institutional integrations.
For sub-$500M EV deals — approximately 85% of M&A volume by deal count — Peony, iDeals, and FirmRoom compete on flat-rate pricing, AI auto-indexing speed, and workstream-by-workstream visitor permissioning. Peony Data Room at $52 per admin per month replaces the $15K-$50K per-deal data room cost typical of legacy VDR providers.
The honest VDR limits to flag:
- Above $500M EV — institutional integrations with QoE providers, law firms, and RWI underwriters matter; Datasite/Intralinks typically have these built-in
- For multi-jurisdictional deals requiring complex data residency — Datasite's regional hosting options often outperform smaller VDR options
- For bank-led mega-deals — banks typically have established VDR preferences that constrain seller's VDR choice
- For deals requiring dedicated workstream platforms — above $500M EV, Litera Transact (deal lifecycle management), Allvue (PE portfolio management), Sourcescrub (origination intelligence) layer on top of the VDR
Bottom line
M&A due diligence runs 6+ parallel workstreams (financial, legal, tax, commercial, HR, IT/cyber, environmental, regulatory) for the first 4-6 weeks of a 14-week canonical timeline. Then the workstreams funnel into ONE serial critical-path chain: QoE → SPA → financing → RWI bind → HSR clock → close. Compression is possible on parallel workstreams (AI-tooled QoE drops from 3-6 weeks to 5-10 days; AI-tooled legal review drops 1-2 weeks of attorney-hours to 3-5 days). The critical-path chain is structurally rigid.
The three timing gates I see kill deal momentum most often: the Week 9 RWI binding gate (carriers require complete DD reports + DDQ logs + agreed SPA reps before binding); the HSR Q1 2026 $133.9M threshold and Second Request risk (30-day clock floors above the threshold; Second Request risk in high-scrutiny sectors); and third-party consents on cross-border deals (lender, landlord, customer, franchisor consents — 30-50% of cross-border deals slip on these).
The single most important deal-team decision: engage RWI carrier in Week 3 and map the consent matrix in Week 1. Both decisions add zero cost but commonly save 2-4 weeks on the close date.
The 2024-2026 reality: 40% of deals miss their original close date per BCG, and two-thirds of those need 3+ extra months. Sign-to-close for PE deals increased 64% from 2023 to 2024 per Goodwin Procter. 88% of dealmakers report sign-to-close has lengthened in the past 3 years. The deals that close on time are the ones where the deal team treats the critical path as the binding constraint, not as a backdrop against which parallel-workstream compression delivers a faster DD report.
Related resources
- Imaging center M&A data room — selling a radiology group in the roll-up wave: payor consent, radiologist retention, and fleet age as the buyer's Big Three
- Medical equipment sale data room — the dossier-driven disposition of high-value imaging equipment: PHI sanitization, buyer qualification, and the service-history file that sets price
- M&A Due Diligence: 6-Phase Playbook + 8 Workstreams — the canonical process guide covering DD timeline by deal size
- M&A Data Room: Setup and Workstream Mapping — data room timeline + impact on DD
- Sell-Side Due Diligence: The 90-Day Prep Pyramid — sell-side prep that compresses buy-side DD
- Hard vs Soft Due Diligence: The 5-Frame Playbook — distinguishing hard-DD workstreams (document-driven) from soft-DD (interview-driven)
- Due Diligence Questionnaire: The 220-Item DDQ Template — DDQ structure mapped to workstreams
- Due Diligence Mistakes That Kill Deals — common workstream-coordination failures
- Commercial Due Diligence: 4-Quadrant Buyer Posture Map — commercial DD timing within DD timeline
- Operational Due Diligence: The 8-System Audit — ODD timing across the parallel workstreams
- State of M&A Data Rooms: 2026 Benchmark — Peony's 733-deal platform benchmark (Q3 2026 edition) behind the bidders-per-room and days-to-first-viewer figures on this timeline
- Financial Due Diligence Explained — the workstream behind the longest bars on this timeline: QoE, the working capital peg, and net debt.
- Buy-Side Due Diligence (2026) — the acquirer's 7-workstream process that runs against this critical path, and the exclusivity-clock sequencing it forces.
Footnotes and sources
- Goodwin Procter — Private Equity Deal Timelines: Turning Delays (October 2025)
- SRS Acquiom — M&A Due Diligence Study (Q3 2024 survey of 150 senior bankers)
- SRS Acquiom — 2026 Deal Terms Study (2,300+ deals, $569B)
- SRS Acquiom — 2025 Working Capital Study (1,200+ deals, $298B)
- FTC — 2026 HSR Threshold Update (January 2026)
- Cleary Gottlieb — 2026 HSR Thresholds Announced
- Pillsbury — FTC HSR Threshold Filing Fee Increases 2026
- Greenberg Traurig — 2026 HSR Merger Notification Thresholds and Fees
- Gallagher — Who Pays the RWI Premium and Retention in 2026
- Kennedys — Negotiating Transaction Documents in 2026 with RWI
- McDermott Will & Emery — RWI Underwriting Process Timeline
- CBIZ — Representations and Warranties Insurance in 2025 M&A
- Treasury — CFIUS Overview
- Foley & Lardner — CFIUS for International M&A
- Morrison Foerster — M&A in 2025 and Trends for 2026
- Deloitte — 2025 M&A Trends Survey
- Synopsys OSSRA — Open Source Security Risk Analysis Report
- BCG — Deals Are Taking Longer to Close (2024)
- Strategex — 80/20 Customer DD Research
- Holland & Knight — FDA What to Watch in 2026
- Centri Consulting — Cybersecurity Hidden Pillar of M&A DD
- Human Renaissance — 2025 M&A Technology DD Benchmarks
- IBM — Cost of a Data Breach Report 2025
- Anders — Quality of Earnings Report Guide
- DueDilio — Quality of Earnings Analysis Guide 2025
- Plante Moran — How Section 382 Impacts NOL Carryforwards
- Emma Legal — Breaking M&A Bottleneck with Faster Legal DD
- Dealroom — 6-Step DD Process 2026
- Allegrow — Navigating the DD Period
- WTW — 2024 M&A Retention Study
- Sampford Advisors — Sell-Side Process Timeline
- Acquisition Stars — Environmental DD for Manufacturing Acquisitions
- RMA Green — Phase I ESA Primer
- Settles Law — Third-Party Consents in M&A
- CMM — Consents and Approvals: The First Gate to Closing
More frequently asked questions
What is the canonical M&A due diligence timeline from LOI to close?
The canonical mid-market M&A DD timeline runs 14 weeks from LOI signing to close, with a 6-week intensive DD phase embedded inside it. The standard 14-week sequence: Week 0 — LOI signing + exclusivity period begins; Weeks 1-2 — Day-1 data room population (target 80%+ by Day 14); Weeks 3-4 — Quality of Earnings preliminary findings + price renegotiation window opens; Weeks 5-6 — Confirmatory DD findings surface (the 'Confirmatory-DD Cliff' where most walk-away findings appear); Weeks 7-8 — SPA negotiation; Week 9 — RWI insurance binding gate; Weeks 10-11 — Financing commitments firmed; Weeks 12-13 — Regulatory clearance (HSR 30-day clock per Q1 2026 rule update with $133.9M threshold); Week 14 — Closing. The 6-week intensive DD phase per Dealroom's 2026 6-step DD framework runs Days 1-42: Days 1-7 (Week 1) data room launch + initial requests; Days 8-21 (Weeks 2-3) first-pass functional reviews across legal/financial/commercial/tech/HR in parallel; Days 22-28 (Week 4) management interviews + site visits; Days 29-35 (Week 5) synthesis + IC memo + cross-functional risk register; Days 36-42 (Week 6) final negotiations + sign-off. Variance by deal size: small acquisitions under $10M often compress to 8-10 weeks total; large and cross-border transactions can run 6-8 months. The 14-week canonical is the median for $50M-$500M private-target deals where neither extreme delay nor extreme compression applies.
What are the 6+ parallel workstreams in M&A DD and how do they coordinate?
M&A DD runs 6 core parallel workstreams (sometimes 8-9 with industry-specific add-ons). Financial DD / Quality of Earnings (Weeks 1-4) — reconciles reported EBITDA to normalized EBITDA, sets the working capital peg, costs $20K-$75K mid-market per DueDilio's 2025 QoE Analysis Guide. Legal DD (Weeks 1-5) — 30-90 days depending on target complexity, with manual document review typically the labor bottleneck. Tax DD (Weeks 2-3) — downstream of QoE; modern AI-tooled tax DD runs 5 days to 3 weeks mid-market; Section 382 study required for stock deals due to NOL limitation. Commercial DD (Weeks 1-3 + customer ref calls Week 5-6) — first-pass market positioning + competitive landscape early; customer reference calls held until Week 5-6 because ref calls signal imminent close to the seller's customer base. HR DD (Weeks 2-4) — 6-week standard timeline; management retention agreements often discovered missing late (Week 5-6), strongest single late-stage walk-away risk per WTW 2024 M&A Retention Study where 72% of acquirers structure retention payments with 75-100% of base salary for C-suite and 12-24 month terms. IT/Tech/Cyber DD (Weeks 2-4) — rapid cyber assessment 5-7 days; comprehensive 3-4 weeks. Plus 3 industry-specific workstreams: Environmental DD (Phase I ESA 2-4 weeks for industrial/RE), Regulatory DD (HSR / CFIUS / FDA depending on sector), and Third-Party Consents (cross-workstream, ALL deals — must be mapped Week 1). The coordination rule: parallel workstreams run independently for Weeks 1-4, then re-coordinate at Week 5-6 synthesis (cross-functional risk register) and again at Week 7-8 SPA exchange. Workstream coordinators typically use a single 'DDQ master' Excel tracker plus a Q&A workflow in the VDR. Peony's visitor groups provide workstream-by-workstream permissioning so each external advisor sees only their assigned scope.
What's the critical path — what's actually on it versus what's parallel?
The critical path is ONE serial chain that cannot be parallelized: QoE finalize → working capital peg set → SPA negotiation → financing commitment drawn → RWI binding → HSR filing → HSR 30-day clock → close. Why each step is serial: (1) QoE must finalize before working capital peg can be set; (2) Working capital peg drives SPA price + adjustment mechanism — 90%+ of private deals now have a working capital purchase price adjustment per SRS Acquiom's 2025 Working Capital Study (1,200+ deals, $298B in finalized PPAs), up from ~50% a decade ago; (3) SPA must be agreed before financing commitments can be drawn (debt commitment letters condition on near-final docs); (4) RWI carrier needs final DD reports + DDQ Q&A logs + agreed SPA reps before binding at Week 9; (5) HSR can only file after signing (signing requires SPA agreement); (6) Cannot close before HSR clock expires (if deal value >$133.9M per 2026 thresholds). What CAN run in parallel: legal corp records review + financial QoE; IT/cyber scan + commercial market study; HR org chart review + environmental Phase I; tax structuring + regulatory consent matrix mapping. The structural implication: compression on parallel workstreams (e.g., 5-day Big Four QoE with AI tooling per Anders, parallel cyber DD via Mandiant or Crowdstrike, parallel HR DD via Aon or Mercer) does NOT change close date if the critical path chain is slow. Most deal teams underinvest in critical-path compression and overinvest in parallel-workstream compression — the result is a faster DD report but the same close date because the SPA-financing-RWI-HSR sequence still takes its time.
How does the HSR Q1 2026 rule change affect deal timing?
The Hart-Scott-Rodino Q1 2026 thresholds went into effect February 17, 2026 per the FTC's January 2026 announcement. The size-of-transaction threshold rose to $133.9M (up from $126.4M in 2025, +6%); size-of-person thresholds rose to $267.8M / $26.8M; Section 8 interlocking directorate threshold rose to $54.4M (up from $51.4M); filing fees range from $35,000 (smallest tier) to $2.46M (top tier, up from $2.39M). The 30-day initial waiting period is unchanged, but the practical interaction matters: any deal that crosses the $133.9M threshold gets a 30-day clock from filing to closing — the structural floor on close date for any deal above the threshold. Cash tender offers retain the 15-day initial waiting period — a strategic-buyer advantage for hostile or competitive deals. The Second Request risk is the real time-killer: if the FTC or DOJ issues a Second Request, the 30-day clock tolls until parties certify 'substantial compliance' — typically months of document collection, privilege review, and data extraction in agency-specified formats. The 30-day clock then restarts from substantial-compliance certification. For 2026 sub-$133.9M deals, HSR is not a critical-path concern — only the larger deals hit the clock. For cross-border deals with EU EUMR filings, CFIUS reviews, or FDI screenings, the regulatory clock can extend well beyond HSR. CFIUS specifically: 30 days short-form / 45 days long-form / 105 days max with investigation plus extension per Treasury's CFIUS overview, with a proposed 2026 'Known Investor Program' for frequent filers reducing review burden. The deal-team rule for HSR: assume the 30-day clock will run in full and plan close 30 days after signing; assume Second Request risk if the deal is in a high-scrutiny sector (healthcare consolidation, big tech, defense, semiconductors, energy).
What gates the RWI insurance binding gate at Week 9?
The Week 9 RWI insurance binding gate is one of the three timing gates I most commonly see kill deal momentum. The mechanics: a buyer purchasing R&W insurance (now in 65%+ of mid-market deals per CBIZ 2025) must complete underwriting before signing, with the policy binding at signing and issuing at or just before signing. The standard RWI underwriting timeline per McDermott Will & Emery: preliminary submission to non-binding quotes 2-4 business days; formal underwriting process 1-2 weeks; underwriting plus binding 7-10 business days if responses are prompt; overall 2-3 weeks total. What gates the bind: (1) Final DD reports from all workstreams — QoE, legal, tax, HR, IT/cyber, commercial — must be substantially complete; (2) DDQ Q&A logs must be substantially complete; (3) Agreed SPA reps and warranties must be in place; (4) Disclosure schedules must be substantially drafted. Without these, the RWI carrier cannot complete its own coverage scope analysis. The 2026 RWI pricing per Gallagher's 2026 RWI outlook: premium 2.0-4.0% of coverage limit (most deals 2.25-3.25% in competitive market); retention 0.5-1.5% of EV at policy inception dropping to 0.25% after Year 1; coverage limit typically 10% of EV. For a $50M deal: $5M coverage, $250K retention, ~$125K-$200K premium. Strategic buyers often absorb both premium and retention in competitive auctions per Kennedys' 2026 RWI outlook. The structural risk: any DD workstream not professionally scrutinized gets excluded from RWI coverage. Under-diligenced cyber risk, under-diligenced HR retention, under-diligenced environmental — all get exclusion endorsements that shift risk back to the buyer.
What's the Confirmatory-DD Cliff — why do most findings surface Week 5-6 not Week 1-2?
The Confirmatory-DD Cliff is the proprietary frame I use to describe the structural reality that most deal-killing findings surface in Weeks 5-6 of DD, not Weeks 1-2. The mechanics: Weeks 1-2 are document review (data room scan, contract review, financial-statement scrutiny) — a high-volume, low-depth activity. Weeks 5-6 are confirmatory DD (management interviews, customer reference calls, site visits, deep-dive on flagged issues, second-pass review) — a low-volume, high-depth activity that often surfaces the findings that get a deal repriced or killed. The pattern across 2024-2026 deals: (1) management interviews in Week 4-5 surface key-person flight risk that wasn't visible in the org chart; (2) customer reference calls in Week 5-6 surface customer-loyalty issues tied to specific account managers rather than the brand or product; (3) second-pass legal review in Week 5 surfaces missing IP assignment chains or change-of-control termination rights in major customer contracts that weren't flagged in the first-pass DDQ response; (4) HR DD in Week 5-6 surfaces missing management retention agreements — the strongest single late-stage walk-away risk per WTW 2024 retention study (where 72% of acquirers structure retention payments and 28% of acquirers have no key-person retention plan at all); (5) operational DD site visits in Week 4 surface process-maturity issues that aren't visible in process documentation. The strategic implication: deal teams should NOT assume that a clean Week 1-2 DDQ response means the deal is clean. The cliff is real and structurally late. For sellers running sell-side prep, this is the case for vendor DD (VDD) — running confirmatory DD on yourself 90 days pre-marketing to surface findings before the buyer does, per the sell-side DD 90-Day Prep Pyramid. For buy-side teams, the cliff means budget should be reserved for Week 5-6 deep-dive scope — typically 30-40% of total DD budget held back for confirmatory work.
What's the Third-Party Consent Long Pole and when does it kill cross-border deals?
Third-party consents are the most-overlooked timing risk in M&A DD — and they often become the long pole on cross-border deals. The five most common consent categories: (1) Lender consents — most senior debt and unitranche facilities have change-of-control acceleration clauses; lender consent typically takes 30-60 days, longer for syndicated facilities; (2) Landlord consents — real estate leases often have anti-assignment provisions; landlord consent typically takes 30-60 days; (3) Counterparty consents — major customer and vendor contracts often have anti-assignment provisions; customer SaaS contracts in particular typically have 90+ day consent timelines; (4) Franchisor consents — franchise agreements typically require franchisor approval for change of control, with 30-90 day timelines; (5) Customer consents on regulated services (healthcare, financial services, government contracts) typically run 60-120 days. The 2026 cross-border survey from BusinessWire reports 88% of dealmakers say sign-to-close has lengthened in the past 3 years and 74% have deals prevented from closing due to entity/SPV delays. Cross-border deals compound consent risk because foreign-direct-investment (FDI) screenings layer on top of HSR/CFIUS (EU EUMR Phase I 25 working days, UK NSI Act 30 working days, German FDI 2-month review). The structural rule: every deal should produce a 'consent matrix' in Week 1 of DD listing every material contract requiring third-party consent, the expected timeline, and the responsible owner. Deals that wait until Week 5-6 to map consents typically miss their close date by 30-90 days. The 30-50% slippage figure I quote: approximately 30-50% of cross-border deals slip past their target close because of third-party consents (vs ~15% of pure-domestic deals).
What's the VDR Population Velocity Curve — what should be uploaded by Day 7 / 14 / 30?
The VDR Population Velocity Curve is the proprietary frame I use to track data room readiness against the canonical DD timeline. The standard mid-market benchmark: Day 7 — 50-60% of materials uploaded (corporate records, financial statements, key contracts); Day 14 — 80% uploaded (most workstreams have substantial materials available for review); Day 21 — 95% uploaded (only confirmatory and management-interview docs missing); Day 30 — 99%+ uploaded with only late-arriving custom requests outstanding. In the Q3 2026 edition of Peony's 733-deal benchmark, the median room took 12.6 days from first opening to its first outside viewer, with a median of 5.5 bidders per room. By the end of the first week of bidder access, reading patterns (which bidders are reading deeply, which are skimming) are already an early read on which bidders will return for confirmatory DD and which will drop. Slow-uploading sellers (Day 14 at 60% rather than 80%) typically lose 2-3 weeks on the close date because critical-path workstreams (QoE in particular) cannot complete on schedule. The most common Day 7 misses: audited financials for prior 3 years (target's auditor often slow on year-end statements); cap table and equity ledger (target's law firm slow to provide); customer contract catalog (target sales team often disorganized); IP assignment chain documentation (the single most-common Week 5-6 surprise gap). Peony's AI auto-indexing accelerates the Day 7 / 14 / 30 curve by classifying uploaded documents into standard DD categories — typical sell-side teams see Day 14 80% upload completion rather than the Day 21 80% completion typical of manual folder organization. Page-level analytics make the bidder-engagement-accuracy signal actionable: by Day 7 the deal team can identify which 30-50% of bidders are likely to return for confirmatory DD. Peony's median is 4 minutes 19 seconds from account creation to the first uploaded document (State of M&A Data Rooms, Q3 2026).
What can you compress safely in DD timeline and what can't you?
Compression is possible on parallel workstreams but NOT on the critical-path serial chain. Safely compressible: (1) Financial DD / QoE — Big Four AI-tooled QoE can drop from 3-6 weeks to 5-10 days for mid-market per Anders 2025 framework; (2) Legal DD document review — AI tools can drop 1-2 weeks of attorney-hours to 3-5 days; (3) Tax DD — AI-tooled tax DD runs 5 days to 3 weeks mid-market; (4) IT/Cyber DD rapid assessment — 5-7 days vs comprehensive 3-4 weeks; (5) Commercial DD first-pass — market positioning and competitive landscape can drop from 2 weeks to 5-7 days; (6) HR DD — 6-week standard can drop to 3 weeks with AI-tooled comp benchmarking. Total parallel-workstream compression: roughly 20-30% off the 6-week intensive DD phase, dropping from 42 days to 28-32 days. NOT safely compressible: (1) The RWI binding gate at Week 9 — carriers require final DD reports + DDQ logs + agreed SPA reps and will not shortcut; (2) HSR 30-day clock for deals >$133.9M — statutory floor; (3) Third-party consents — lender, landlord, customer, franchisor timelines are externally controlled and run 30-120 days; (4) Confirmatory DD in Weeks 5-6 — management interviews, customer ref calls, and site visits require time-on-target that can't be AI-accelerated; (5) Financing commitments — credit committees meet on fixed schedules and require final SPA before drawing commitments; (6) Regulatory approvals beyond HSR (FDA QMSR effective February 2 2026 for medical device deals; CFIUS for foreign investment; EU EUMR for EU mergers). The implication: AI-tooled compression saves time on parallel workstreams but rarely saves time on the close date unless the parallel compression unlocks earlier critical-path-chain progression. The deal teams that hit aggressive close dates typically front-load the critical-path chain — early QoE engagement before LOI signing, early SPA drafting starting Week 1, early RWI carrier engagement starting Week 3 (instead of Week 7).
